Construction Schedule: How to Plan and Track It With Buildpeer
Reading
8
min
Share it with your network
ininstafaceshare

A construction schedule lays out the work: what gets built, in what order, how long each activity takes and what depends on what. Building it is the easy half. Keeping it tied to what actually happens in the field is where most projects lose it.

A few weeks into the job, the file says one thing and the site says another. Not because the schedule was badly built, but because keeping it current takes more time than anyone has.

‍

What a construction schedule should include

A construction schedule is the ordered set of activities needed to deliver a project within a given period. To be useful in the field, it should carry:

  • activities and activity groups
  • start and finish dates, and durations
  • predecessors and the critical path
  • a responsible party per work front
  • contract milestones
  • the project work calendar
  • planned progress against actual progress

With that in place, anyone on the team can answer what should be running, what is finished and what is slipping. The condition is that the schedule stays current, and that depends less on whoever built it than on whoever reports from the field. Worth reading first: what it takes for a field team to actually use a control platform.

This is not a small gap. In conversations with 224 general contractors, developers and design firms across Mexico and Latin America between April and September 2026, 33% raised the distance between physical progress and the baseline on their own, and 41% raised how hard it is to report progress to management.

Base: 224 companies, April to September 2026. Each company could raise more than one topic. This is not a representative industry survey: these were teams already looking to fix something.

‍

Where spreadsheets fall short

A spreadsheet is fine for building the schedule. The limits show up in maintaining it, once there are several work fronts and several people entering data.

The file going around is not always the current one. It gets emailed, downloaded, edited and sent back. As more people touch it, three versions with the same file name end up in circulation, and the argument stops being about the job and starts being about which file is right. It is the same problem that shows up when you centralize project communication and documents.

Progress gets entered twice. The site engineer reports progress in the daily report, then someone re-enters the same percentage into the schedule. Because it is duplicate work, it gets postponed. And once it is postponed, the schedule stops matching the job.

The S-curve gets rebuilt for every meeting. Comparing planned against actual means cross-referencing the schedule with the reports at every cut-off. In practice the curve gets refreshed when there is a meeting, not when the job changes: by the time it shows the variance, the variance already happened.

Progress has nothing behind it. A line item reads 80% and there is no way to tell who reported it, when, or on what evidence. Same with dates: one slips and the sheet does not record who moved it. When a delay or a pay application is disputed, it comes down to one person’s word against another’s. It is the same missing backup that makes it hard to give a developer the information they need from the contractor running the job.

None of this means the spreadsheet was badly built. It means it is doing a job it was never designed for: being the single source for a number that changes every day and is entered by several different people.

‍

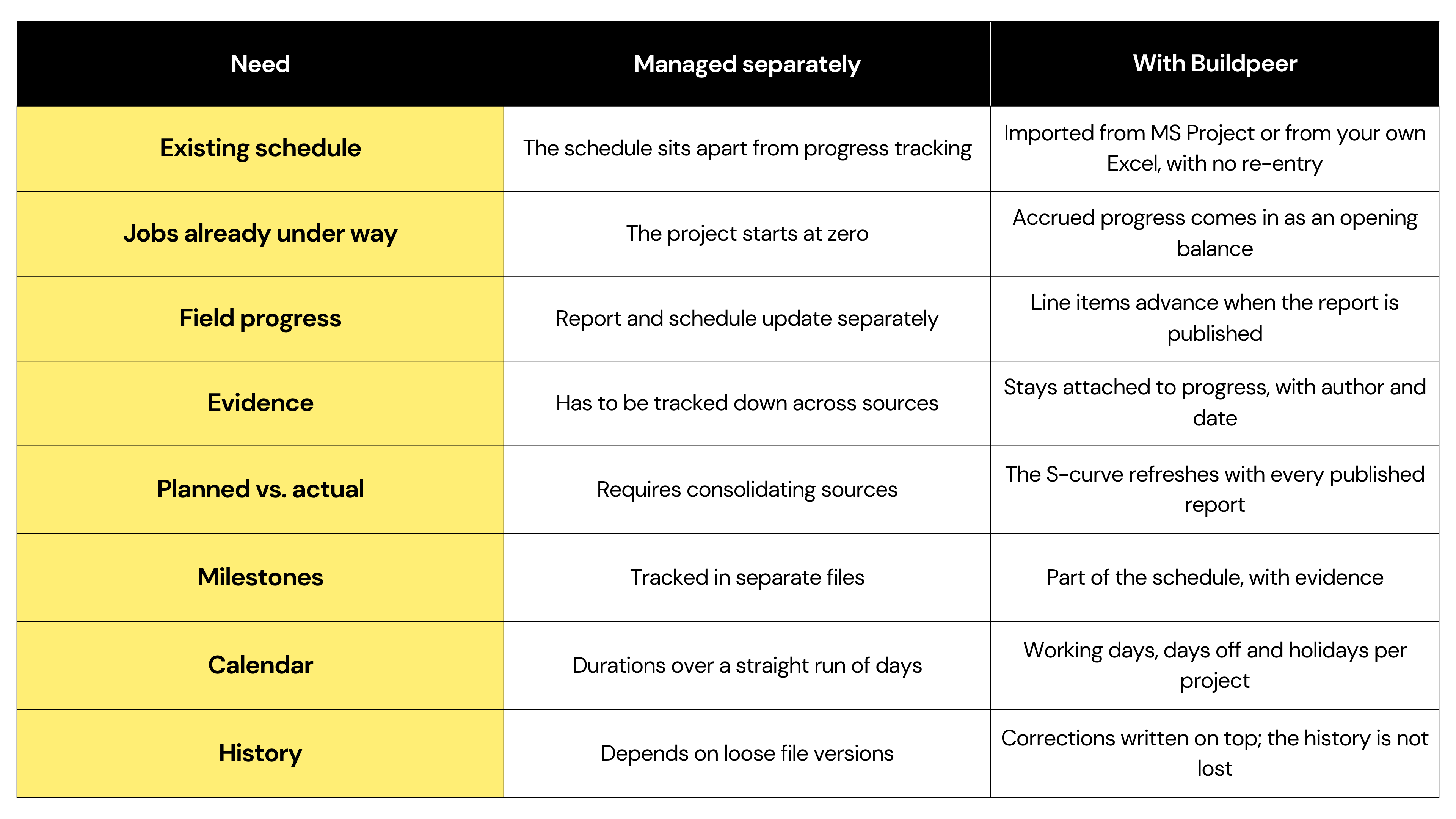

How the construction schedule works in Buildpeer

MS Project stays the source of truth. Buildpeer does not plan the job for you: it connects the schedule to the information the site already produces.

Import what you already have

The MS Project file comes in with its groups, activities, durations, predecessors and milestones, with no templates and no manual entry. If the team works in Excel, the assistant reads the sheets, columns and hierarchy, proposes a configuration and shows a full preview before you confirm. And if the job is already under way, accrued progress comes in as an opening balance, so the project starts with its history instead of at zero.

Progress comes from the field report, not a second entry

The site engineer links each section of the report to a line item in the schedule. When the report is published, those line items advance, with the report photos and notes attached as evidence. The report is filled as a draft day by day and published once a week, so official progress only counts once it is published.

Every movement carries an author, a date and the report it came from, and corrections are written on top of the history instead of erasing it. That is what matters when a pay application is disputed or an audit comes around. It follows the same logic as digital tools for effective remote collaboration in construction.

An S-curve and a Gantt chart that do not get rebuilt

The curve compares planned against actual progress week by week and refreshes with every published report. The Gantt chart shows activities against the project calendar, with the "Today" line marked and each line item’s progress on its own bar. Both can be read as a percentage or by value, and each project sets its own currency.

Milestones and the real work calendar

Milestones such as a handover, a utility connection or a start date are marked as met or not met from the report itself, with the evidence behind them. The work calendar is set per project, including official Mexican holidays in one click, so planned progress follows the real calendar of that job rather than a straight run of days.

Two things the field notices: when entering progress, the site engineer sees how the line item total will land and how much has been spent against budget, with a warning if either goes over; and the module always shows the date of the last reported progress, so nobody confuses "no delay" with "no recent data". All of it can be captured from a phone, the same way the team works when the site keeps running without a connection.

‍

What changes with Buildpeer

Transforma la forma en que gestionas tus proyectos de construcción.

The platform does not plan the job for the team: durations, sequencing and execution calls still rest with the people who know the work. What changes is how that plan stays alive once execution starts. Buildpeer is built for general contractors, developers and expansion teams in Mexico and Latin America, designed to be adopted first by the field, not only by management.

‍

When is it time to leave the spreadsheet?

Not every project needs the same level of control. If one person runs a small job and can keep everything current, a spreadsheet is enough. That changes when several of these signals show up:

  • several people updating or reading the schedule
  • multiple work fronts
  • reports that live apart from the schedule
  • no clear way to tell which version is current
  • management asking for updates constantly
  • progress that has to be backed by evidence
  • several projects to oversee at once

At that point the question is no longer how to build the schedule. It becomes how to keep it connected to operations without adding admin work for the team, which is where teams running store openings across multiple cities usually run into trouble first.

‍

Closing

A construction schedule does not fail because it was badly built. It fails because keeping it current costs more than the team can sustain, and it stops matching the job.

When progress comes out of the same report the site engineer already writes, maintenance stops being a separate task. Book a demo and we will show you how to bring in the schedule your team already uses and connect it to how your projects are tracked.

‍

Preguntas Frecuentes

How often should a construction schedule be updated?

The update cycle works best when it matches the reporting cycle on site. If the team reports weekly and the schedule is updated monthly, for three weeks the job is being measured against stale information.

Can Excel be used to create a construction schedule?

Yes, especially when the project is small and only a few people are updating it. The difficulties arise when progress needs to be continuously updated with information from different people, reports, and workstreams.

Can I import a Microsoft Project file into Buildpeer?

Yes. The file is imported with its groups, activities, durations, predecessors, and milestones, and the cumulative progress is retained as the opening balance. If your team doesn't use Project, you can also import your own Excel file, with a preview available before confirming.

What is the purpose of an S-curve in a construction schedule?

To compare scheduled versus actual progress throughout the project and identify discrepancies between what should have been executed and what was reported. This can be viewed as a percentage or in monetary amounts.

Why link progress to evidence?

Because a percentage only shows what was reported, not what actually happened. Linking it to reports, dates, responsible parties, and photographs preserves the context, which is exactly what you need when an estimate is disputed or an audit takes place.

Transform your construction projects
check
Centralize information management
check
Automate key processes
check
Accelerate the growth of your company
Contact Sales
Transform your construction projects with Buildpeer, the intuitive platform that centralizes information management.

During our personalized Buildpeer demo, you will be able to:

Buildpeer is the construction platform built for real-world operations in LATAM. Easy to use and easy to adopt.
Visualize how Buildpeer acts as a single source of truth for your entire team.
We'll show specific workflows based on your use case.
We conclude with a suggested implementation roadmap tailored to your operations, including estimated timelines and benefits.
CONSTRUCTION MANAGEMENT PLATFORM

Discover the power of Buildpeer

During our personalized demo of Buildpeer will allow you to:

Buildpeer is the construction platform built for real-world operations in LATAM. Easy to use and easy to adopt.
See how Buildpeer acts as a single source of truth for your entire team.
We show specific workflows based on your use case.
We finish with a suggested implementation roadmap tailored to your operation, including estimated timelines and benefits.
Schedule your demo and we will show you what your operation can achieve when it has the right tools.
  • Registro y seguimiento de subcontratistas
  • Requisición y recepción de materiales
  • Control de calidad en entregas de obra
  • Control de avance de obra semanal
  • Gestión de planos y cambios de diseño
  • Cierre y entrega de obra al cliente
  • Control de fuerza de trabajo en obra
  • Gestión de no conformidades y retrabajos
  • Coordinación de visitas de supervisión externa
+6,000 users are already operating with Buildpeer
0%
What are you primarily looking to manage?
What is your biggest challenge on the job?
